Dreaming of your independent house construction process or a modern villa construction stages India? The house construction step by step process in India—especially for G+1 duplex house construction timeline or 3BHK plot to house completion guide—is exciting yet daunting. In 2026, with cement at ₹350-420/bag, TMT steel ₹62-68/kg, and 10% material inflation, cost overruns hit 25-40%, delays stretch to 24 months, and contractors exploit vague home building checklist India 2026.
Fear not! This ultimate step by step home building guide India delivers a residential construction stages in India roadmap for North India (Delhi NCR, Uttar Pradesh, Uttarakhand, Rajasthan). Tailored for 1BHK to 4BHK, G+1 to G+3, it includes house construction process India 2026 approvals (RERA 2.0, seismic norms), realistic timelines (12-24 months), per sq ft costs (₹1700-3200), and cost of constructing 3BHK house breakdowns. Avoid common house building mistakes, control your budget, and finish on time.
At Construction Estimator India, we provide accurate quantity takeoff, BOQ for every stage, and contractor bid analysis to save you lakhs. WhatsApp plot details (e.g., 30×40 ft Agra plot, G+2 3BHK) to +91 8630676890 for free preliminary cost estimate + personalized home building checklist India 2026.

Pre-Construction Stage – Planning & Approvals
This foundation of your plot to house completion guide prevents 50% of legal/financial headaches. In 2026, digital portals speed things up, but errors cost dear.
Detailed Steps:
- Plot Purchase & Due Diligence (1-2 months): Verify freehold/leasehold via registry office. In UP, use IGRSUP portal; Rajasthan BHUMI for jamabandi. Check setbacks (3-5m sides).
- Geotechnical Soil Test (7-10 days, ₹12,000-25,000): Bore 10-20m; CBR value >5% for shallow foundation. Uttarakhand seismic Zone IV needs piles (+15% cost).
- Architectural & Structural Design (30-45 days, ₹60-120/sq ft): AutoCAD/Revit plans with elevations, sections. Include rainwater harvesting (mandatory in Delhi NCR).
- Building Plan Sanction (30-60 days, ₹25-60/sq ft): Submit 6 copies to MCD/ADA/Nagar Palika. 2026 e-approval via single-window portals.
- RERA Registration (if >500 sqm or phased selling): ₹15,000-60,000; quarterly updates mandatory.
- NOCs & Utilities: Fire NOC (G+2+), environment clearance (hilly areas), GST (threshold ₹40 lakh post-2026 update), electricity/water from DISCOM.
North India Tips: Monsoon-prone Rajasthan—elevate plinth 2-3ft. Total timeline: 2.5-5 months. Cost: 6-10% budget.
Pitfalls: No layout approval = demolition risk.
Action: WhatsApp +91 8630676890 for free pre-construction checklist.
Stage 1: Foundation & Excavation
Your house’s roots. Weak here = cracks/costs ₹10-20 lakh to fix.
Sub-Steps:
- Site clearing, centering with lime powder.
- Excavation (manual/JCB; 5-15ft depth).
- Lean PCC (M15, 4″ thick).
- Footing reinforcement (8-16mm @150mm c/c), M20-M25 concrete pour.
2026 Rates: Sand ₹80-110/cft, aggregate ₹900-1200/ton. Labour: ₹1200-1600/day per jodi.
For 2000 sq ft plot: 15-35 days. Cost: ₹240-380/sq ft (14-16%).
Pro Tip: Vibrator compaction; cure 14 days.
Stage 2: Plinth Beam & Column Construction
Raises structure above soil moisture; critical for flood-prone UP/Gangetic plains.
Sub-Steps:
- Plinth beam (12″x9″-18″) with 4-6#12mm bars, stirrups @6″.
- Column formwork (Ply/steel), 4-8#16mm verticals.
- Concreting (pump/mixer), backfill with murum/sand.
Materials: Fe500 steel (₹64/kg). Pitfall: Undersized beams sink.
Timeline: 25-40 days. Cost: ₹220-340/sq ft (11%).

Stage 3: Slab & RCC Structure (Ground + Upper Floors)
Heavy lifting—25% budget here. 2026 norm: Fly ash in concrete (20%) for sustainability.
For G+1/G+2:
- Shuttering (cuplock system, rent ₹50/sq ft).
- Slab mesh (10mm @150mm), beam steel.
- Slab (5-6″ thick), drop beams (9″x12″).
- Deshuttering after 21 days.
Seismic Add-Ons: Ductile detailing per IS 13920.
Timeline: 50-75 days/floor. Cost: ₹420-650/sq ft (26%).

Table: Floors vs Time
| Floors | Timeline | Extra Cost % |
| G+0 | 45 days | Base |
| G+1 | +60 days | +20% |
| G+2 | +50 days | +35% |

Stage 4: Brickwork & Masonry
Encloses spaces. Shift to blocks for 20% faster, 15% cheaper.
Options:
- Red bricks (₹9-13 each, 1:6 mortar).
- AAC blocks (₹45-60/block, thinner walls).
Sub-Steps: English bond, door/window openings, RCC lintels (4-6″).
Timeline: 35-50 days. Cost: ₹260-370/sq ft (13%).
North Tip: Fly ash bricks in Delhi NCR (cheaper, eco).
Stage 5: Plastering & Waterproofing
Prevents leaks—60% of post-handover complaints.
Sub-Steps:
- Chicken mesh at junctions.
- External (12-15mm, 1:5), internal (10mm, 1:4).
- Waterproof slurry (2 coats).
Rates: Neeru finish ₹22/sq ft. Timeline: 25-40 days. Cost: ₹160-280/sq ft (9%).
Stage 6: Flooring, Doors & Windows
Aesthetics kick in. Vitrified > ceramic for durability.
Details:
- Flooring: Kajaria tiles (₹55-120/sq ft), granite stairs.
- Doors: Flush/solid teak (₹350-550/sq ft).
- Windows: Fenesta UPVC (₹280-450/sq ft, double-glazed).
Timeline: 30-45 days. Cost: ₹320-480/sq ft (13%).
Stage 7: Electrical, Plumbing & Painting
Integrate systems. 2026: Smart wiring (₹ extra 10%).
Breakdown:
- Electrical: Concealed conduits, 4-way switches, DB (₹160-280/sq ft).
- Plumbing: SWR pipes, anti-siphon traps (₹220-350/sq ft).
- Painting: Primer + 2 emulsion coats (₹55-90/sq ft).
Timeline: 35-50 days. Cost: ₹270-450/sq ft (11%).

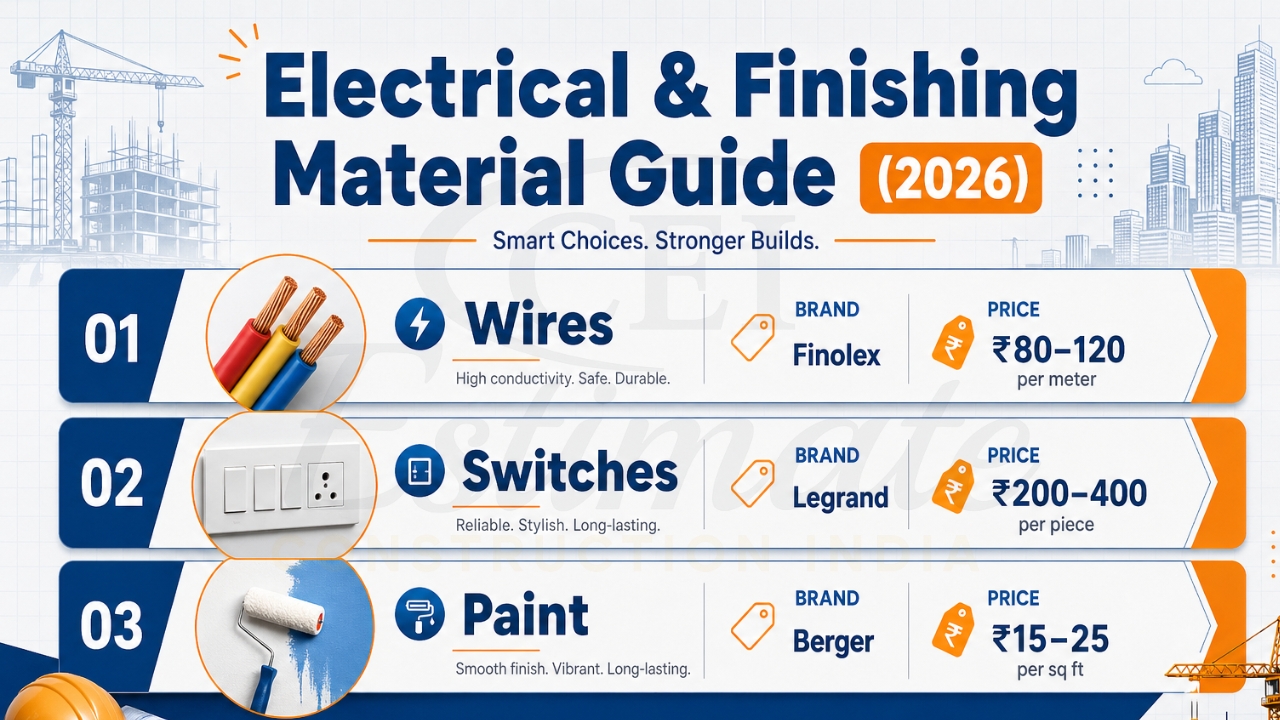

Table: Fitting Brands
| Category | Recommended | Price Range |
| Wires | Finolex | ₹80-120/m |
| Switches | Legrand | ₹200-400/pc |
| Paint | Berger | ₹15-25/sq ft |

Stage 8: Finishing & Handover
Polish and certify.
- Kitchen cabinets, sanitaryware, landscaping (₹120-250/sq ft).
- OC/Completion cert (30 days).
Timeline: 20-35 days. Cost: ₹110-230/sq ft (4%).
Realistic Timeline & Cost Breakdown for House Construction in India 2026
For 1500 sq ft G+1 (North India): Total ₹28-42 lakh (+GST/land).
| Stage | Duration | % Cost | Cost/sq ft (₹) | Key 2026 Rates |
| Pre-Con | 2.5-5 mo | 7% | 120-220 | Architect ₹80/sq ft |
| Foundation | 15-35 d | 15% | 240-380 | Steel ₹64/kg |
| Plinth/Col | 25-40 d | 11% | 220-340 | – |
| RCC Slab | 50-75 d/flr | 26% | 420-650 | Concrete ₹5200/m3 |
| Brickwork | 35-50 d | 13% | 260-370 | Bricks ₹11/ea |
| Plaster | 25-40 d | 9% | 160-280 | – |
| Flooring/D&W | 30-45 d | 13% | 320-480 | Tiles ₹80/sq ft |
| Elect/Plumb/Paint | 35-50 d | 11% | 270-450 | Wires ₹100/m |
| Finishing | 20-35 d | 4% | 110-230 | – |
| Total | 14-22 mo | 100% | ₹1900-3000 | Inflation +8% |
Scales: 3BHK G+2 (2500 sq ft): +40% time/cost.
Common Mistakes to Avoid During House Construction
Expanded List (save ₹5-15 lakh):
- No BOQ—quotes mismatch reality.
- Advance payments >30%.
- Inferior cement (test ISI mark).
- Ignoring ventilation (add ₹2 lakh later).
- No insurance (theft/fire).
- Monsoon starts without tarps.
- Verbal changes—no extras BOQ.
How Construction Estimator India Helps You Build Your House Successfully
We specialize in North India house construction estimation 2026, from 1BHK to villa.
4-Step Process:
- WhatsApp +91 8630676890 (plot dims, floors, budget).
- Free prelim report (48 hrs): Cost of constructing 3BHK house etc.
- Full BOQ + takeoff (Excel/PDF; ₹5000-15000, often free for leads).
- Ongoing: Stage audits, quote comp (spot 20% overcharges).
Case Study: Agra G+1 client saved ₹8 lakh via our steel BOQ.
Ready to Build? WhatsApp Now for Your Free House Construction Cost Estimate!
Click/Tap: WhatsApp +91 8630676890 → “G+1 Estimate, 40×60 Agra plot”. Free BOQ + timeline in 24 hrs!
FAQ: House Construction Step-by-Step Process in India
What is the step-by-step process to build a house in India?
Pre-con → foundation → plinth → RCC → masonry → plaster → flooring → MEP → finishing (detailed above).
How long does it take to construct a house in India in 2026?
14-22 months for G+1; factors: weather, floors.
What are the major stages of house construction with timeline?
Table shows: RCC longest (2-3 mo/floor).
How much does it cost to build a house in India per square foot?
₹1900-3000 North India; premium +20%.
What approvals are needed before starting house construction?
Plan sanction, soil test, RERA/NOCs.
What is G+1 house construction process?
Standard stages; 14-18 mo, ₹30-45 lakh (1500 sq ft).
2 BHK house construction steps and cost?
900 sq ft: ₹18-27 lakh; quick 12 mo.
Duplex house construction timeline India?
G+1: 16 mo avg.
Cost of constructing 3BHK house in UP 2026?
₹40-60 lakh (2000 sq ft).
Home building checklist India 2026?
Our free WhatsApp service provides it.
Villa construction stages India?
Same + luxury finishes (+25% cost).
Plot to house completion guide time?
18-24 mo total.
Independent house construction process RERA?
Not mandatory unless commercial.
